The Hidden Costs of Building a Custom Home in Northern Virginia (Beyond Permits)

Permit fees get all the attention, but they're not the line item that catches most homeowners off guard. Stormwater management, soil conditions, utility upgrades, and architectural coordination regularly add tens of thousands of dollars to a Northern Virginia custom home budget and almost none of it shows up in a typical online cost estimate. We already wrote about what Arlington building permits actually cost right now. This is the follow-up: what else is hiding in the budget once the permit is issued.

Stormwater management is the big one

Any project that disturbs more than 2,500 square feet of a property needs an LDA (Land Disturbing Activity) permit and a stormwater mitigation plan in Arlington. That threshold is easier to hit than people assume considering the disturbance radius extends 10 feet around any work area on the house and 5 feet along a water line upgrade all the way to the street connection. Include the foundation, an impervious driveway, and a utility trench, and you're often over the line before you've thought about it.

Once you're in LDA territory, the real costs stack up fast: civil engineering, additional site work, the stormwater system installation itself, required native plantings, and landscaping. Arlington has also tightened its stormwater rules in recent years with new systems now requiring underground "voidless" dry well tanks instead of the older gravel-filled dry wells. That’s a requirement expanding beyond only large land-disturbance projects and simply becoming the standard for all dry wells. All told, the stormwater requirement alone can add somewhere in the range of $50,000–$75,000 to a project once civil engineering, soil work, the system installation, and landscaping are all accounted for. Getting a specific number from your builder before civil engineering has been designed is difficult because it varies immensely by lot, existing conditions, proposed design, roof plan, and lot grading.

Architectural coordination mistakes

The other hidden cost isn't a line item at all, but a review gap. Designing large renovations, additions, and custom homes is genuinely complex and small mistakes on paper are more common than most homeowners would guess. This could be a truss drawing that doesn't match load-bearing points in the framing plan or a set of window rough openings that require custom sizes. Truss design happens early in the process of designing a custom home in an effort to avoid complex and costly issues later on. It's best to talk about windows and doors as early as the initial design meeting, so rough openings and center lines are consistent with the plans and follow a window line that fits your budget. The cost savings of staying within a single line of windows instead of going to custom sizes will be thousands of dollars.

Real cost ranges for common surprises

  • Utility tap fee (water meter upgrade): Arlington requires upgrading a ¾" to a 1" meter for any house with more than 3 bathrooms. The county fee is $5,295, plus excavation and plumbing can add $5,000–$10,000 more.

  • Demolition of an existing house: Roughly $30,000 for demo and debris haul-away, plus permit cost.

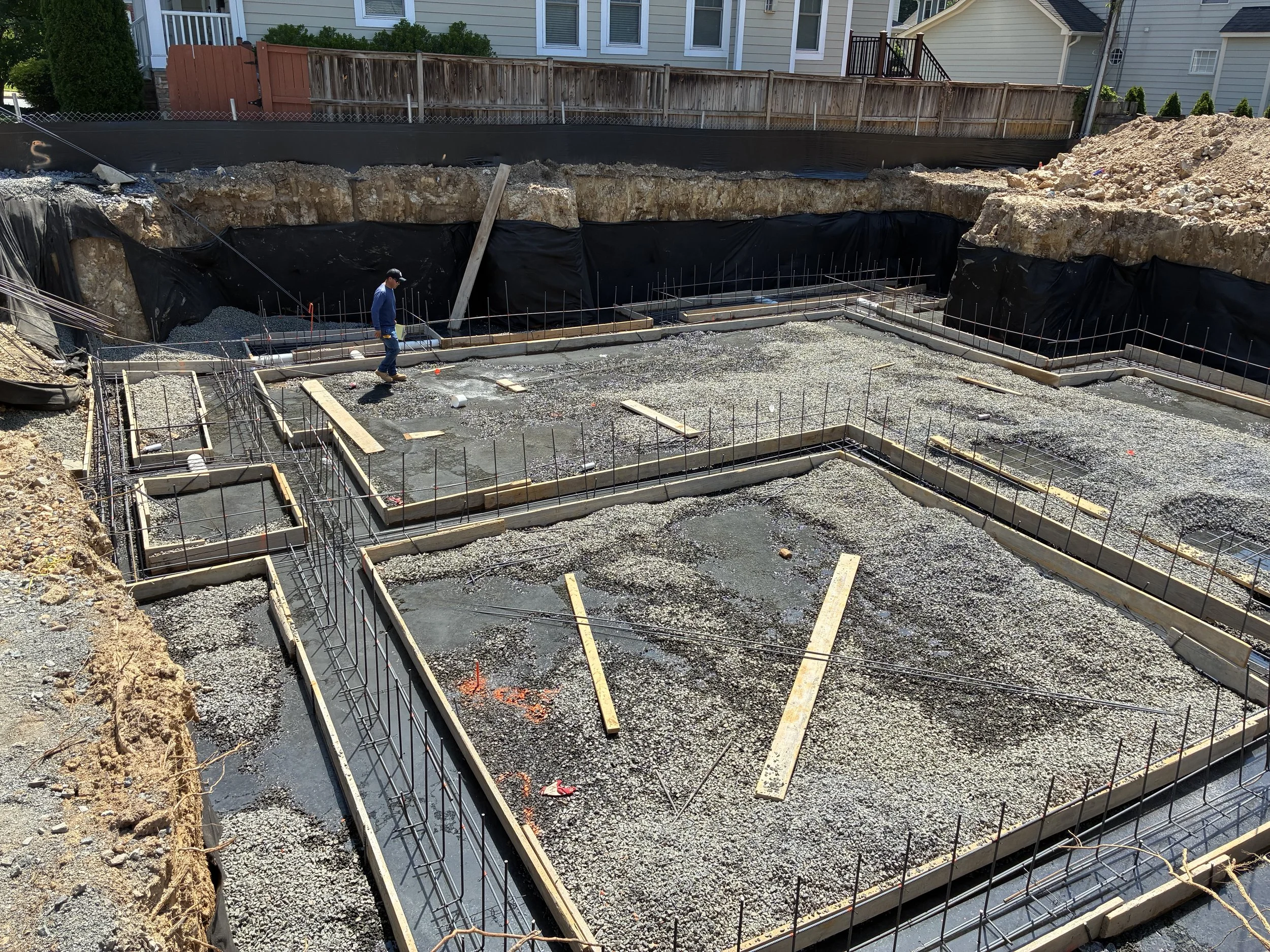

  • Soil remediation: Roughly $30,000-$40,000 in hard costs depending on house size (extra dirt excavation, extra stone, and dirt haul-away), plus about $5,000 in soft costs for engineering fees, and about a week minimum of added time to the schedule.

  • Stormwater management system: Civil engineering, permit costs, system installation, and required landscaping is commonly $50,000–$75,000 combined on a project that triggers the LDA permit. This number speaks to the stormwater system requirements for a new home and it can be less expensive for a renovation.

Item What Drives the Cost
Utility tap fee (water meter upgrade) Arlington requires upgrading a ¾" to a 1" meter for any house with more than 3 bathrooms. County fee up to $5,000, plus excavation/plumbing $5,000–$10,000 more.
Demolition of an existing house Roughly $30,000 for demo and debris haul-away, plus permit cost.
Soil remediation Roughly $30,000-$40,000 in hard costs depending on house size (extra dirt excavation, extra stone, and dirt haul-away), plus about $5,000 in soft costs for engineering fees, and about a week minimum of added time to the schedule.
Stormwater management system Civil engineering, permit costs, system installation, and required landscaping. This is commonly $50,000–$75,000 combined on a project that triggers LDA.

A real project where utility timing changed everything

We had a project that was a small addition above a garage on an existing home and we needed to temporarily relocate the overhead service wire to a temporary power pole so we could safely build. We contacted Dominion when we pulled permits, expecting the standard turnaround. Four months of construction later and Dominion still hadn't completed the permanent power reconnection. The timeline we'd been given wasn't enough for them to fully scope, approve, and complete the work on their end. We worked with them the entire time, but it held up our final inspections since permanent power was the last thing standing between us and closeout. Fortunately, it was a renovation on a home that already had a certificate of occupancy so the family could move back in without issue. We just couldn't get the project fully closed out until Dominion finished their work a couple weeks later. It's not a complaint about Dominion specifically, but it's a reality of working with utility companies on any Northern Virginia project and it's something we plan around.

A moment of candor

On another project we were opening up a kitchen and dining room in an existing Arlington home to create one seamless space. To get the clean sight lines and flush ceiling the owner wanted, the beam spec had to change from wood to steel mid-project. This affected both budget and schedule. We were able to get a revised drawing by the engineer submitted and approved concurrently while sourcing and installing the steel. We were able to sequence other trades around it so we didn't lose time elsewhere and it worked, but it's exactly the kind of problem that could ruin a family's experience with a builder if they're not upfront and communicate clearly during the project.

Material costs are moving, too

As of this writing, we've seen roughly a 6% increase on aluminum and steel products this week, along with cabinet-specific increases from several vendors, window price increases across the board, among many others. Also, in recent months it’s commonplace for vendors to add fuel surcharges on deliveries with oil markets in flux. We’ve also seen a siding supplier pull from our local market causing fiber cement siding prices to increase due to less competition. None of this is dramatic on its own, but it adds up and it's part of why we build a contingency into every budget.

Want a real number for your lot, not an estimate? Let's walk through your site specifically.

New Urban Homes

New Urban Homes is a boutique builder run by brothers Clayton and Christian Hughes — custom homes, additions, and renovations across Arlington and Northern Virginia since 2018. Eight years of growth almost entirely by word of mouth. Cost-plus pricing, honest numbers, and the bones built right: foundation, framing, and waterproofing are never where we cut corners.
